Preparing for PFI Handback: Ensuring Fire Safety and Asset Integrity

Home/Insights/PFI Handback

Press Release version of article published in Fire Safety Matters– August 2024

The Private Finance Initiative (PFI) was introduced in 1992 and ran through until 2018. Overall, in England, there are over 550 projects, with an initial capital expenditure of £46 billion1. The projects encompass a broad range of public sector assets such as schools, hospitals, prisons, and other critical infrastructure. The typical contract term for these projects is 30 years and at the expiry of the contract, the asset is returned, ‘handed back’ to the public sector – a small number of these projects have already been handed back, with many more to follow in the near future. Fire Safety will be a key consideration as part of the handback process.

A 2020 survey by the National Audit Office identified that a significant proportion of authorities felt underprepared for PFI expiry. The report that followed, ‘Managing PFI Assets and Services as Contracts End,’ 2  set out a number of key findings, including:

One of the main recommendations set out in the report was that the Infrastructure Projects Authority (IPA) should proactively coordinate and develop a program of support that can be made available to authorities, which can be accessed here.

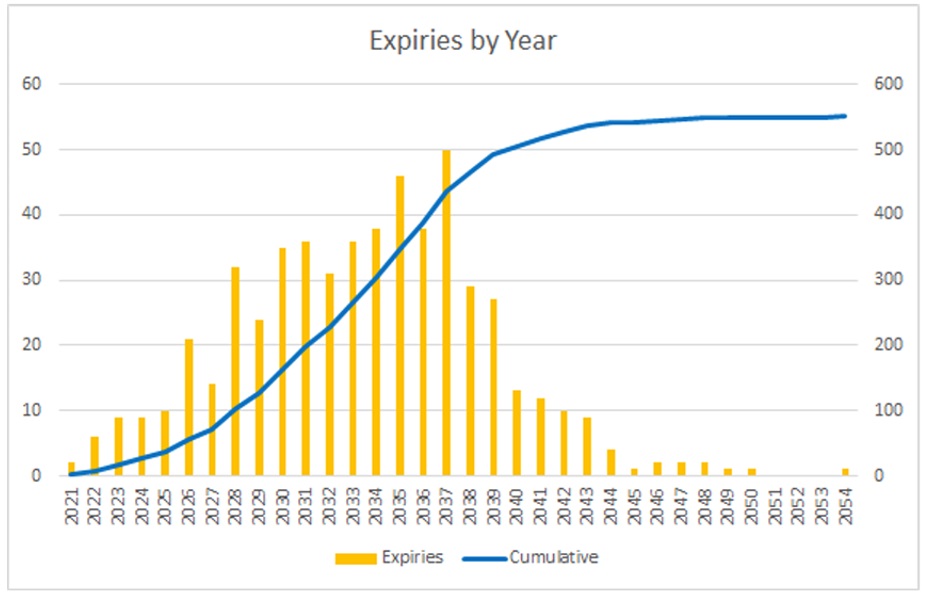

The IPA recommends that expiry and transition planning should commence at least seven years before the expiry date. Many of the PFI projects are now within this window, with circa 78 projects expiring between April 2021 and December 2027, 91 projects in 2028-30, 288 projects in 2031-37, with the bulk reaching expiry by 2043, and a small amount that run on until 2054, see figure 1 below. This will create a wave of handbacks, and construction professionals involved face a unique and significant set of challenges in managing the handback of assets to the public sector, requiring early preparation, careful planning, and collaboration to ensure a smooth transition and minimize disruption.

IPA, Managing the Risks of PFI Contract Expiry, https://assets.publishing.service.gov.uk/media/6113b3068fa8f506cbee532c/IPA_Expiry_Support_Plan.pdf

A number of challenges may present themselves during handback, including:

While there are challenges associated with PFI handback, there are also opportunities within this complex process.

A successful handback requires meticulous planning and collaboration between all stakeholders. Key steps include:

As part of the PFI handback process, confirmation should be provided that a comprehensive set of fire safety checks have been conducted to ensure the buildings meet all necessary safety standards and regulations, which typically would include:

The above checks are the main ones to be carried out, albeit the list is not exhaustive, and they may vary project by project, as may the responsibility who performs them

To date, only a small number of PFI disputes have progressed to court, mainly due to most PFI projects include dispute resolution procedures that deter litigation. However, evidence suggests that the number of court cases is rising and may continue to do so as more projects approach handback.

A notable case that reached The Technology and Construction Court (TCC) with a specific focus on fire safety was St James’s Oncology SPC Ltd v Lendlease Construction (Europe) Ltd and Lendlease Construction Holdings (Europe) Ltd. The project agreement and design-build contract for a new Oncology Centre at St James’ Hospital in Leeds outlined extensive technical and construction design criteria, including adherence to various NHS health technical memoranda, specifically HTM 81 (fire precautions) and HTM 2007 (electrical services supply and distribution).

Deviation from these criteria was permissible only if the design could be justified through a fire-engineering approach and met or exceeded the standards of HTM 81. The design criteria mandated 60-minute fire compartmentation for each space within the electrical plant room, which housed transformers, generators, and switchgear. However, the electrical plant room was constructed as a single fire compartment without discrete compartmentation.

The judge found that Lendlease failed to justify the plant room’s compartmentation as compliant with a fire-engineering approach and did not demonstrate how these installations met the necessary safety standards. Furthermore, the judge noted the absence of significant approval for the “as-built” design from the Hospital Trust, Building Control, or the fire and safety authority. Nonetheless, any such approvals would not have absolved Lendlease of their responsibility to comply with the design and build contract requirements at all times.

The task of handing back PFI assets will be spread over many years and require dedicated resource. Steps should be taken in advance to:

Make use of Government support and expiry toolkits: The government via the IPA will play a crucial role by providing advice to the public sector on managing PFI handback. Expiry toolkits are already available at https://www.gov.uk/government/publications/preparing-for-pfi-contract-expiry

Build in-house expertise and capacity: The Public Sector should plan ahead and invest in building internal expertise and capacity to manage PFI handback effectively. This includes training for key personnel and potentially considering joint ventures with other authorities facing similar challenges.

Seek advice: Engaging independent advisers with specialised knowledge of PFI contracts and surveying will provide invaluable guidance and support throughout the handback process.

PFI handback presents both challenges and opportunities. By understanding the issues, utilising available resources, and collaborating effectively, those responsible for Fire Safety can play a crucial role in contributing to a smooth and successful transition, safeguarding public assets and service continuity.

By Anthony Walker
FRICS MIFireE, Director at Sircle
